Reducing flood risk for communities and strengthening economic resilience - the Lower San Joaquin River Project protects more than 235,000 residents and critical infrastructure in Stockton.
Current Status The project encompasses 23 miles of levee improvements and two closure structures at Fourteenmile Slough and Smith Canal. The construction is phased as follows:
iFrames are not supported on this page.

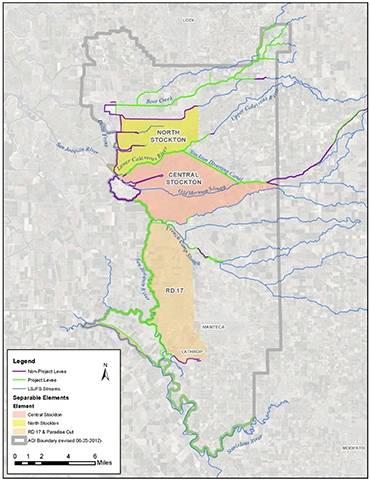

View Larger Interactive Map Study Area Map (2017)
Construction on the Smith Canal Gate Project began in 2020, as part of the Lower San Joaquin River Project. Constructed by SJAFCA, partnered with Reclamation Districts 1614 and 828, the project consists of a floodwall along the San Joaquin River from Dad’s Point to the eastern boundary of the Stockton Golf & Country Club, tying into the existing levee. The floodwall features a gate for tidal exchange and boat access to Smith Canal, and will remain open unless there is a flood event. More information can be found on the SJAFCA Smith Canal webpage.
Type of Work: Levee fix in place with the addition of a cut-off wall, geometry reshaping, and waterside erosion protection.
Location: Stockton, at the western border of the Brookside housing development, and north of March Lane along the Tenmile Slough.
Length: Approx. 5,900 ft.
Dates: Scheduled construction start 2025.
Other Info: Upon completion, the levee will be Federally operated. The waterside of levee is farmland.
Type of Work: Levee fix in place with the addition of a cut-off wall, as well as the addition of waterside erosion protection.
Location: North Stockton west of Interstate 5 and north of Schooner Drive to Sturgeon Road.
Length: Approx. 8,400 ft.
Dates: Scheduled construction start 2028.
Other Info: Phase A is the second planned reach to be improved under the Lower San Joaquin River Project. Upon completion, the levee will be Federally operated. The waterside of levee is farmland.
Type of Work: Levee fix in place and new levees, with the addition of a cutoff wall, height improvements, geometry improvements, and a closure structure.
Location: North Stockton along the Fourteenmile Slough.
Length: Approx. 10,400 ft.
Dates: Scheduled construction start 2032.
Type of Work: Levee fix in place with the addition of a cutoff wall, seismic fixes, and levee reshaping and geometry improvements.
Location: Right bank of the Calaveras River, south of March Lane to N. El Dorado Street (Phase C-2), including a small portion North of the Calaveras on the San Joaquin River (Phase C-1, reaches TS10L and TS20L).
Length: Approx. 28,600 ft.
Type of Work: Levee fix in place with the addition of a cutoff wall, geometry improvements, height improvements and retention walls.
Location: Left bank of the Calaveras River, north of Monte Diablo Avenue to N. El Dorado Street, including a small portion South of the Calaveras on the San Joaquin River near Smith Canal.
Length: Approx. 27,500 ft.
Dates: Scheduled construction start 2035.
Type of Work: Levee fix in place with the addition of a cutoff wall, construction of new levees, levee reshaping and geometry improvements.
Location: South of the Port of Stockton along the San Joaquin River, French Camp Slough, and Walker Slough, adjacent to Van Buskirk Park to S. El Dorado Street.
Length: Approx. 30,400 ft.
Dates: Scheduled construction start 2033.
Type of Work: Levee fix in place with the addition of a cutoff wall and height improvements.
Location: North Stockton from Mosher Slough east to Thornton Road.
Length: Approx. 10,700 ft.
